Learn more about #LESNERBRIDGE construction at SDCC.info.

” Temporary Daytime Lane Reductions on Lesner Bridge on Tuesday” #LESNERBRIDGE

Virginia Beach Public Works has announced that there will be single lane closures on Lesner Bridge tomorrow, Tuesday, January 13, 2015, between the hours of 9 a.m. and 3p.m.

The lane closures will be on both eastbound and westbound Shore Drive between Vista Circle and East Stratford Street.

Crews will be restoring the faded temporary pavement markings in these areas.

For additional information, contact Chris Wojtowicz at cwojtowi@vbgov.com, or (757) 385-4131.

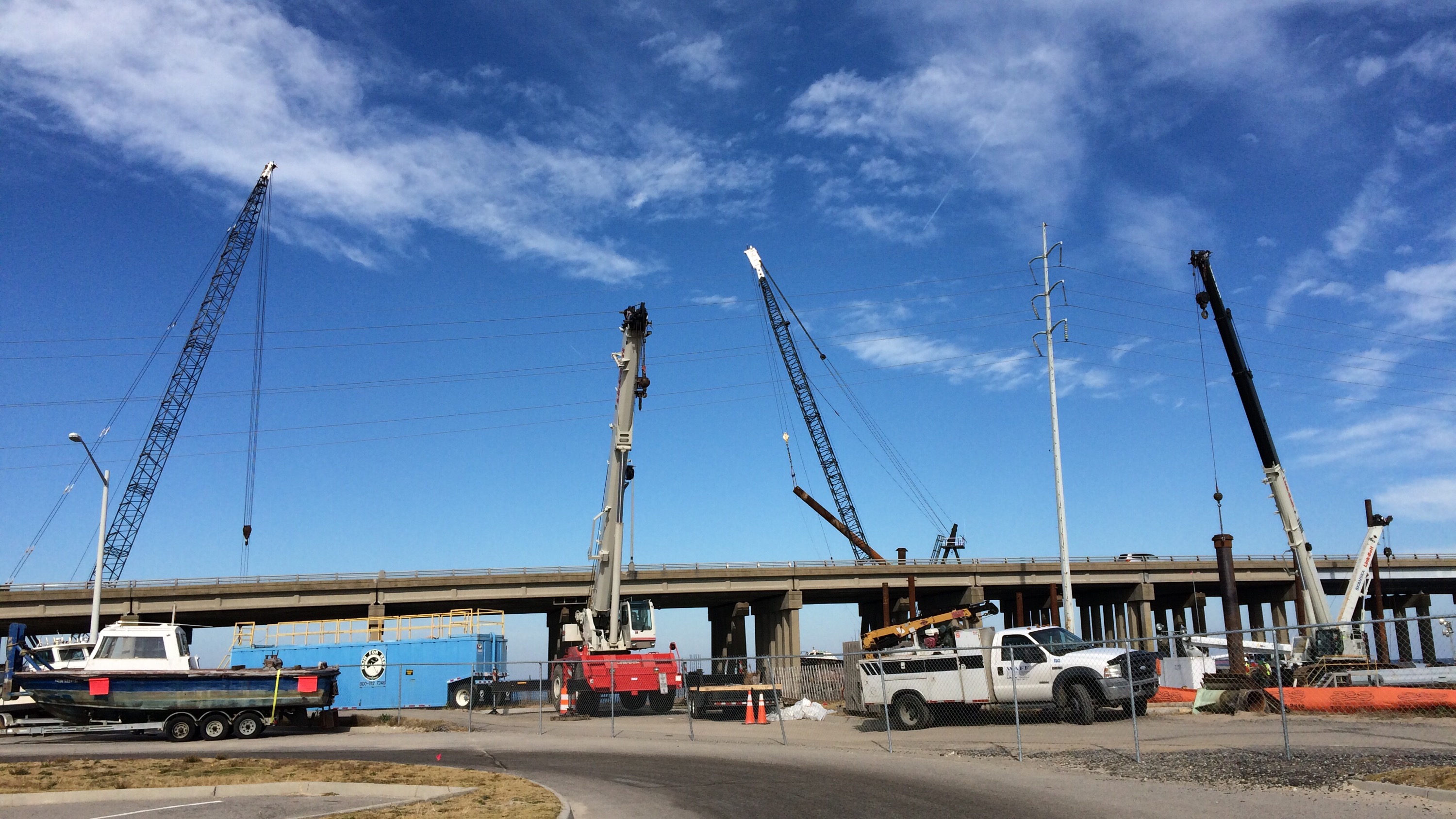

2015/01/img_1724.jpg

#LESNERBRIDGE update from Project Manager – “The City will be addressing bump on eastbound Shore Drive, located in the outside lane at the Vista Circle intersection . . .”

HOORAY FOR FIXING BUMP!

Ahem.

January 9 2015 UPDATE:

Friends:

I hope that all of you have had a safe and enjoyable holiday season. Now it’s back to work and back to our Lesner Bridge Project updates!

The cold temperatures and blustery winds aren’t helping, but work on the new westbound (WB) bridge and temporary bulkhead began again this past Monday (1/5/2015) after the holiday break. Also, form work for the first bridge segments have been assembled at the casting yard in Portsmouth (Atlantic Metrocast Inc. next to the Jordan Bridge). The steel reinforcement on several of the new bridge segments have been tied and pouring of the first concrete segment will begin in approximately one week (see photo below). [Note: The new Lesner Bridge will have a similar appearance as the Jordan Bridge shown in the background.]

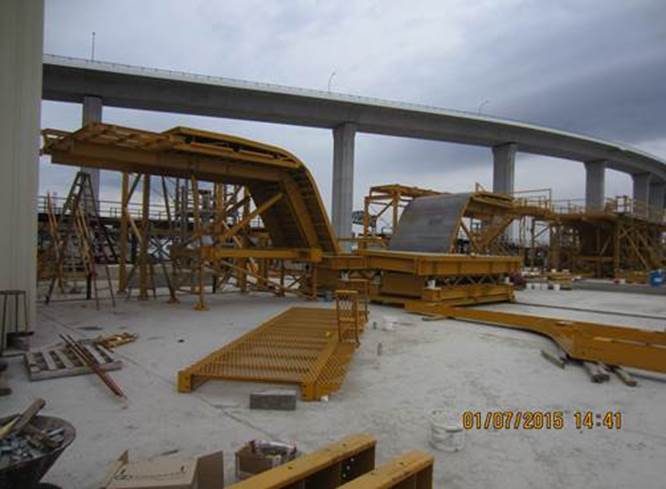

unnamed-4

Now some quick notes on the latest construction progress:

Ø Construction of the new bridge abutment “A” located on the west side of the new WB bridge has been completed.

Ø The foundation cap for Pier #1 (first pier located east of Abutment A) has been completed. Steel reinforcement and formwork for the support column that is being built on this cap is now being assembled and will be in place by the end of next week .

Ø The foundation cap for Pier #2 (second pier located east of Abutment A) is now being constructed. Steel reinforcement and formwork for the foundation cap is currently being placed and readied for the scheduled concrete pour on Monday, January 12, 2015.

Ø Installation of drilled shafts at Pier #3 continues. One of the five shafts for this foundation has been completed. Work on the second shaft began on Wednesday (1/07/2015), and will be completed by tomorrow, Saturday the 10th. The remaining drilled shafts for this pier is scheduled to be complete by 1/23/2015.

Ø Work on the WB bridge approach in front of 3556 On the Bay condos (Shore Drive/East Stratford Street) continues. The concrete retaining wall, utilities, and temporary wire wall are all being installed – concurrently – at this location. It is expected that both the temporary wire wall (next to WB Shore Drive) and the new textured concrete retaining wall will be completed by Wednesday of next week (1/14/2015). Once these items are completed, the contractor will begin installing the new 16-inch water main up to the new bridge abutment. Some utility work will be needed in the intersection of East Stratford Street and Shore Drive as part of this new water main tie-in and construction. Once we have a schedule for this this utility work we will send out another update.

Ø Work on the WB bridge approach next to the old Duck-In property (Shore Drive/Page Avenue) also continues. A portion of the concrete footing for the new retaining wall has been poured and the area prepared for the placement of the pre-cast concrete retaining wall panels. The first of these textured concrete retaining wall panels will be installed at this location on or about January 14, 2015.

Ø The developer of the Duck-In site is currently constructing a seawall as part of their new development for the property. Where this private seawall meets the City’s right-of-way, the City will extend the seawall under the new bridges and tie into the existing bulkhead located on the south side of the bridges at the Virginia Pilots Association. The City’s bridge contractor has recently installed a portion of the City’s seawall between the existing WB Lesner bridge and the private seawall. The remainder of the City’s seawall will be installed once both existing bridges are demolished.

Ø As many of you have noticed over the past month there have been several lane closures on westbound Shore Drive between Page Avenue and East Stratford Street. Several of these closures were needed to repair several portions of the temporary concrete barrier service and others were needed to remove the sand that had accumulated on the roadway. We have asked the contractor to provide better notice of these daytime lane closures so that we can better inform you of these events. There was a single lane closure on both eastbound and westbound Shore Drive between Page Avenue and East Stratford Street today between the hours of 9:00 AM and 3:00 PM. The bridge contractor was repairing several potholes that have developed on Shore Drive. Time permitting, he was also going to re-stripe the temporary pavement markings that have faded over the past few months.

Ø The City will be addressing bump on eastbound Shore Drive, located in the outside lane at the Vista Circle intersection (just before Starbucks®). We are waiting for the cost estimate from the Public Works annual service contractor so that we can prepare the work order and schedule this work. We expect this estimate sometime next week. We will provide an update of when this work will be performed as soon as we get the schedule from the paving contractor. Essentially, we will mill out the EB portion of the intersection and then overlay with asphalt to match the existing elevation of the concrete turn lane at Vista Circle to remove this bump.

Lastly, the construction of the temporary bulkhead at the Lynnhaven Dredge Material Storage Site (LDMSS) is nearing completion. All of the concrete cap for this bulkhead will be completed next week. Dredging in front of this temporary bulkhead will likely begin the last week of January and will be coordinated with the City’s annual Crab Creek dredging maintenance contractor.

That’s it for now. Have a great weekend, and please drive safely!

-Chris

Christopher J. Wojtowicz, P.E.
Project Manager
City of Virginia Beach
Department of Public Works
Municipal Center-Bldg 2
2405 Court House Drive
Virginia Beach, VA 23456-9031
Phone: (757) 385-5785
Fax: (757) 385-5668
email: cwojtowi@vbgov.com

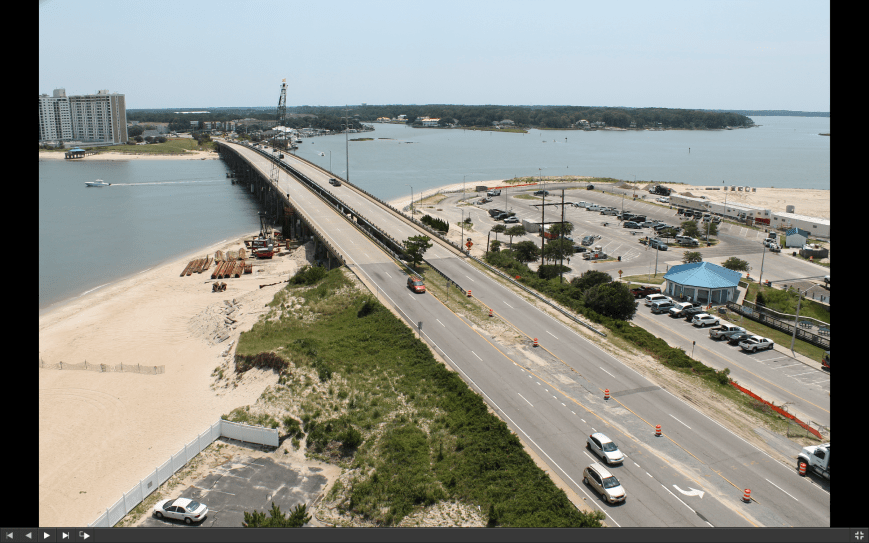

Screen shot of construction cam photo taken at 1215 JUL14 2014 12:15pm. The first photo!

Screen shot of construction cam photo taken at 1215 JUL14 2014 12:15pm. The first photo!

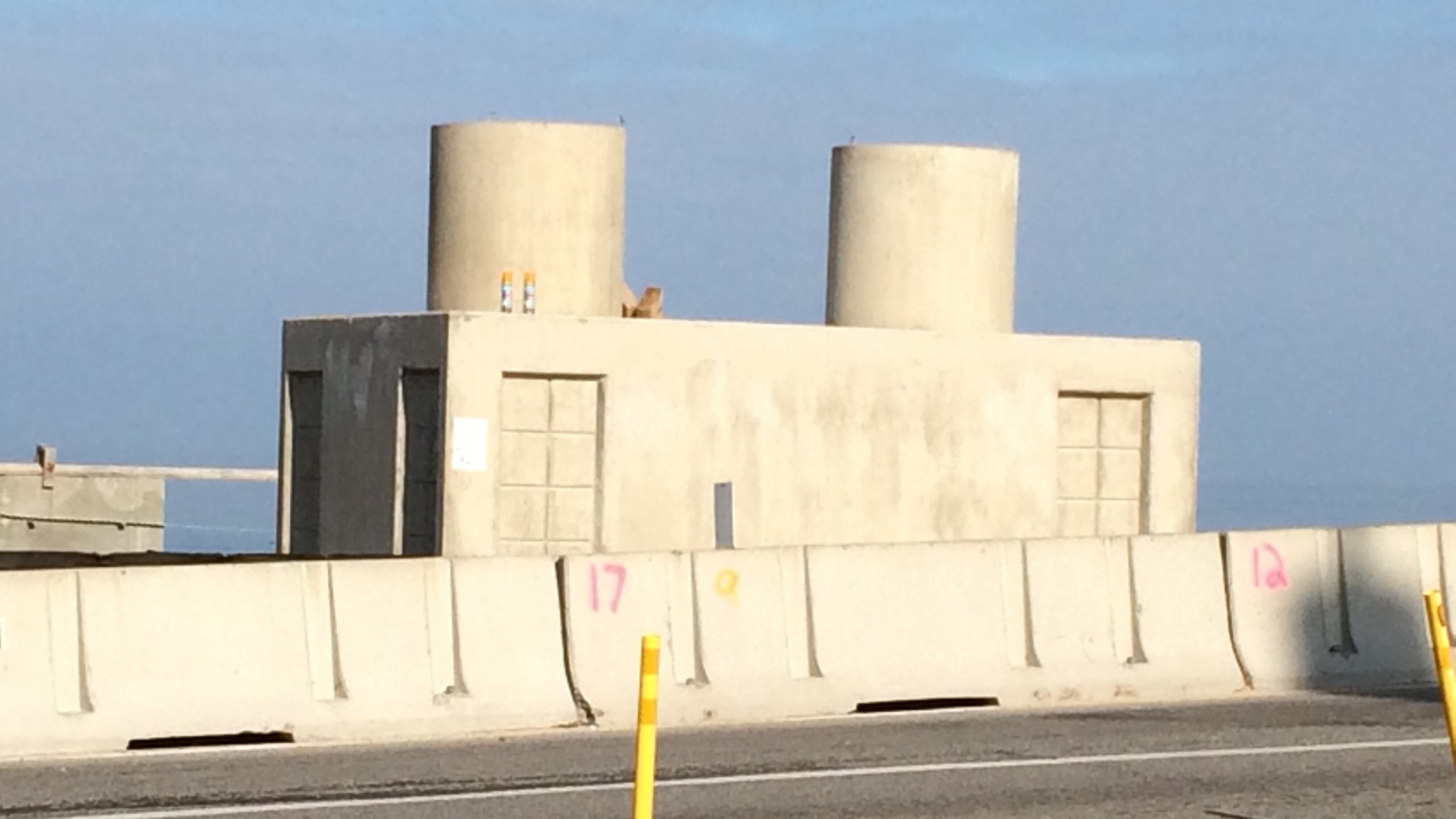

#LESNERBRIDGE CONSTRUCTION SIGN IN LANE NOW

Be safe people!

East side heading west bound, construction sign is blown sideways partially into right lane.

Public Safety has been contacted.

/home/wpcom/public_html/wp-content/blogs.dir/ca1/18933209/files/2015/01/img_3027.png
/home/wpcom/public_html/wp-content/blogs.dir/ca1/18933209/files/2015/01/img_3028.jpg

“The coalition believes Shore Drive can and needs to be safer for pedestrians and drivers. And what has reinforced that in their minds is the recent death of 53-year-old Kenneth Allen. He died last week after being hit while crossing Shore Drive on foot.”

Coverage including video at WAVY.com.

Williams and Brown believe enforcement could lead to more awareness of pedestrians and crosswalk laws. They said this will be part of the Shore Drive Community Coalition’s safety initiative for the coming year, and they plan on bringing it before the city.

Some residents have also called for continuous sidewalks on Shore Drive and more crosswalks.

View comments and add your own to continue the conversation at WAVY TV story. Or comment below by clicking “LEAVE A COMMENT”.

Sorry, oh all knowing and all seeing benevolent Shore Drive Community Coalition, but you are trying to legislate STUPID.
Reduce the speed limit, they more boldly cross without the cross walk
Put up barriers, they will jump them.
I know this will sound harsh, but it is the Darwin theory in effect.
The stupid and week WILL be culled from the gene pool.

Clearly there can be more down to educate the users of this vital multi-modal thoroughfare.

4 examples, did you know:

§ 46.2-923. How and where pedestrians to cross highways.

When crossing highways, pedestrians shall not carelessly or maliciously interfere with the orderly passage of vehicles. They shall cross, wherever possible, only at intersections or marked crosswalks. Where intersections contain no marked crosswalks, pedestrians shall not be guilty of negligence as a matter of law for crossing at any such intersection or between intersections when crossing by the most direct route.

The governing body of any town or city or the governing body of a county authorized by law to regulate traffic may by ordinance permit pedestrians to cross an intersection diagonally when all traffic entering the intersection has been halted by lights, other traffic control devices, or by a law-enforcement officer.

Source: Virginia General Assembly Legislative Information System

§ 46.2-924. Drivers to stop for pedestrians; installation of certain signs; penalty.

A. The driver of any vehicle on a highway shall yield the right-of-way to any pedestrian crossing such highway:

1. At any clearly marked crosswalk, whether at mid-block or at the end of any block;

2. At any regular pedestrian crossing included in the prolongation of the lateral boundary lines of the adjacent sidewalk at the end of a block;

3. At any intersection when the driver is approaching on a highway or street where the legal maximum speed does not exceed 35 miles per hour.

(contd)

Source: Virginia General Assembly Legislative Information System

Sharing the Road
Drivers share the road with many other users: pedestrians, bicyclists, moped and motorcycle riders, trucks and buses, recreational vehicles and other vehicles of all shapes and sizes. It is your responsibility to adjust your driving to avoid other drivers’ mistakes and assure everyone’s safety.

Source: Virginia Department of Motor Vehicles, Section 3: Safe Driving (24 page PDF)

Central to this evaluation will be the understanding that Shore Drive serves as the sole east-west transportation corridor in the City north of the I-264 / Virginia Beach Boulevard corridor. As such, from a land use perspective, it needs to be considered as a multimodal corridor and not solely as a vehicular corridor. Increased densities of development in the corridor demand that pedestrian amenities are more fully addressed in all aspects of the development process, from the rezoning and conditional use permit stage through to the development plan approval and inspection stage. The goal of improving the level of transportation services for a wide variety of users – pedestrians of all types, cyclists, in-line skaters, varied recreational users, transit users, as well as vehicle operators – and the interrelationships between these various users and land uses in an area characterized as being first and foremost as a resort community and not as a resort destination is suggested. Accordingly, both public and private proposed development criteria need to be evaluated from a multimodal perspective to ensure that the needs of these varied users are addressed. Since increasing roadway capacity in the area has strict limits, given the City Council directive that Shore Drive remain a four lane facility for the foreseeable future, greater emphasis needs to be placed on reducing intra-corridor trip demand, particularly where non- vehicular transit among various uses in the corridor can be promoted and encouraged.

Note:Emphasis ours.

Source: Excerpt from conclusion of COVB adopted Shore Drive Safety Task Force Recommendations 2006
View, and download Shore Drive Safety Task Force Recommendations from VBGov.com. (18 Page PDF)

Note: This is one document officially adopted by the City of Virginia Beach to be used for planning, construction, design and funding of infrastructure and other amenities for the Shore Drive community.

SHARE THE ROAD

SHARE THE ROAD

First in a series for 2015.

Starting today: “Drivers 75-years and older will now have to renew their driver’s licenses every five years, and it must be done in person. Also, when they do renew, they must pass a vision test. Finally, if a mature driver is found guilty of breaking a traffic law, a judge could require the person to take a crash-prevention course.”

View video and more at WAVY.com.

“We’re actually going to see an increase in safety for all of these drivers,” said Georjeane Blumling, Vice President of Public Relations for AAA Tidewater Virginia.

The new law is named after Darren Morrell, a 32-year-old Oakton man killed in 2011 by an elderly driver who turned into traffic. Darren’s Law makes driving rules more strict for senior citizens.

View the Legislation and notes at Virginia’s Legislative Information System.

Mature driver crash prevention. Provides for a course in mature driver motor vehicle crash prevention and provides that such course is an option for the court in adjudicating defendants. The bill also lowers the age at which drivers are required to appear before the DMV for renewal from 80 to 75 and requires that licenses issued to persons age 75 or older be valid for no more than five years. The bill contains a delayed effective date.

Senior Programs | Tune up your driving skills and refresh your roadside knowledge at AAA of Tidewater.

Would you like to use your experience to become a better driver and pay less for you automobile insurance? AAA’s Senior Defensive Driving course is a two-day, four hour per day class designed to reduce crashes involving mature drivers by increasing the understanding of how age affects driving decisions, and how these decisions can alter your risk.

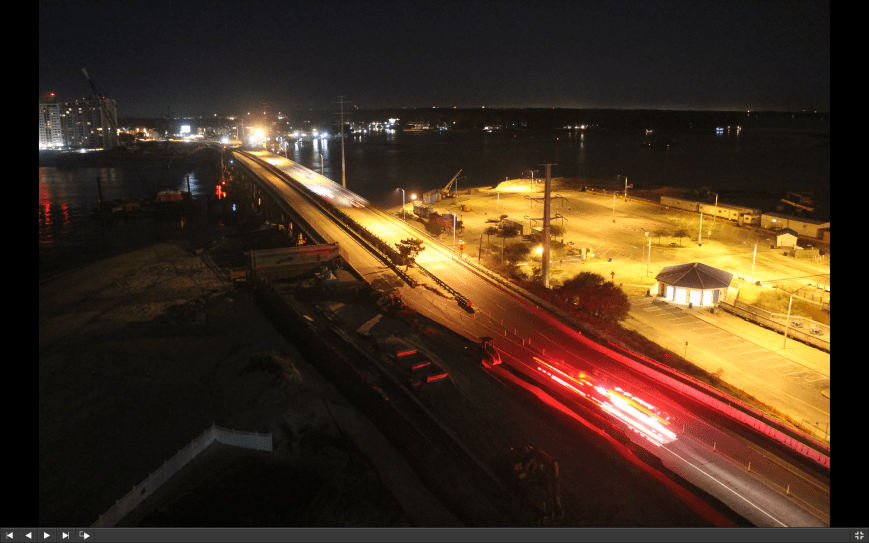

Screen shot of construction cam photo taken at 1200am JAN1 2015. Happy New Year!

Screen shot of construction cam photo taken at 1200am JAN1 2015. Happy New Year!

“We hope that once the project is finished, the improvements will improve access and visibility so these businesses are affected in a much more positive way.”

Coverage at WTKR.com.

“People would have to go to a detour through the neighborhood,” she said. “I had tons of customers email me and say ‘I didn’t think you were open because of the construction.’ They thought I was completely closed.”

/home/wpcom/public_html/wp-content/blogs.dir/ca1/18933209/files/2014/12/img_2609.jpg

The Twelve Days of Christmas (The Shore Drive Version)

It only seemed fitting with 12 days until Christmas and the recent Lesner Bridge update (minus the speed bump fix)…..



Twelve deflated tires

Eleven misalignments

Ten angry emails

Nine nasty tweets

Eight wheelbarrows of asphalt

Seven hardhats shoveling

Six hour work window (9am to 3pm)

Five Orange Cones

Four flagmen warning

Three rollers smoothing

Two lanes a-opening

And a SPEED BUMP fixed on Shore Drive

#LESNERBRIDGE update from Project Manager – We hope that this project update will assure you that crossing the Lesner Bridge during this busy time will be a “non-event”.

December 12 2014 UPDATE:

Friends:

I am sure that many of you are busy with your holiday shopping and planning for all kinds of events over the next several weeks as we approach the end of 2014. We hope that this project update will assure you that crossing the Lesner Bridge during this busy time will be a “non-event”.

Let’s start with GOOD news:

For these next two weeks there are no scheduled daytime lane closures within the Lesner Bridge project limits.

Hampton Roads Sanitation District (HRSD) has completed their work on the existing sanitary sewer forcemain in WB Shore Drive and will require no further lane closures. HRSD has de-mobilized their construction crews located at Shore Drive/Rockbridge Road and at Shore Drive/Kleen Street.

As for the latest bridge construction progress:

Ø Construction of the new bridge abutment “A” continues on the west side of the Lynnhaven Inlet. The first concrete pour on the new bridge abutment took place on Wednesday, October 29th. Placement of the reinforcing steel and formwork for the second tier of the abutment will take place the week of November 3rd. The last concrete placement for this bridge abutment is taking place today, December 12th.

Ø All of the drilled shafts at Piers 1 and 2 of the new westbound (WB) bridge have been installed. Over the next two weeks the contractor will continue with drilled shaft installation at Pier #3, the first in-water pier to be constructed on this project. Concrete placement for the foundation cap at Pier #1 is also taking place today, December 12th.

Ø Work on the WB bridge approach in front of 3556 On the Bay condos (Shore Drive/East Stratford Street) continues. The concrete retaining wall, utilities, and temporary wire wall are all being installed concurrently at this location. As the grade in this area is built up to plan elevations, folks should begin to see how much higher the new bridge will be. The top of the wooden formwork for Abutment A will be the new elevation of the bridge deck.

Ø Work on the WB bridge approach next to the old Duck Inn property (Shore Drive/Page Avenue) also continues. A portion of the concrete footing for the new retaining wall has been poured and the area prepared for the placement of the pre-cast concrete retaining wall panels. Work on the new seawall (closer to the water’s edge) has begun within this area.

The City is coordinating their seawall construction with the private construction contractor building the private seawall on the Point Chesapeake property. The City’s seawall starts at the right-of-way line located north of Shore Drive and will continue south until it connects to the existing bulkhead located south of Shore Drive at the Maryland Pilots Association. The private seawall connects to the City’s seawall at the right of way line and continues north along the dune line towards Cape Henry Towers.

The temporary bulkhead at the Lynnhaven Dredge Material Storage Site (LDMSS) continues. The tie-back system and placement of all the reinforcing steel on the new bulkhead is now complete. Approximately half of the concrete cap has been place on the bulkhead. Work will continue on the bulkhead over the next several weeks to form and place the remainder of the bulkhead cap.

As a final note, the construction contractor will not be working over the holidays; and no work will take place on the project between December 24th, 2014 through January 5th, 2015.

That’s it for now. Have a safe driving weekend!

-Chris

Christopher J. Wojtowicz, P.E.
Project Manager
City of Virginia Beach
Department of Public Works
Municipal Center-Bldg 2
2405 Court House Drive
Virginia Beach, VA 23456-9031
Phone: (757) 385-5785
Fax: (757) 385-5668
email: cwojtowi@vbgov.com

No update on “speed bump” in slow lane on east side of #LESNERBRIDGE at Vista Circle as you can see.

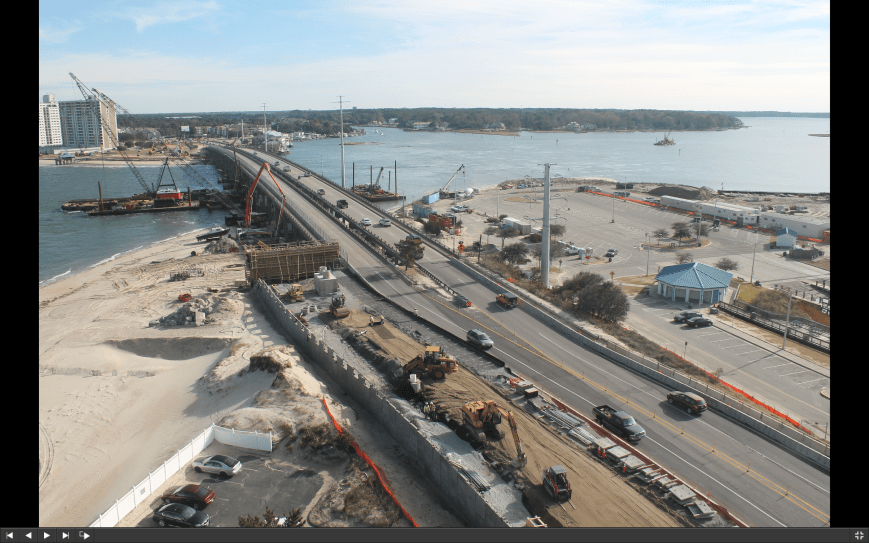

Screen shot of construction cam photo taken at 1130am DEC12 2014

Screen shot of construction cam photo taken at 1130am DEC12 2014

McLean Contracting fact sheet for #LESNBERBRIDGE

Very informative.

View the 22 page PDF at McLean Contracting website.
Download the 22 page PDF Fact Sheet here.

Step3ScreenShotLB
ScreenShotPrettyLBRPicLB

Zoomed in photo from December 2 2014 at 1130a

Zoomed in photo from December 2 2014 at 1130a

Comprehensive Plan Open House – Thursday Nov. 13th, 7:00 to 9:00pm at John B Dey School

[Note: Thank you for the many emails pointing out we had the incorrect date initially. You passed the test.]

Get Involved!  It’s Your City and Your Future

Thursday November 13, 2014

7:00pm to 9:00pm

John B. Dey Elementary School  Click here for a map

Open House Agenda
Welcome & Introductions (7:00-7:10)
Open House Purpose & Format (7:10-7:15)
Comprehensive Plan Overview Presentation (7:15-7:45)
Open House Station Visits (7:45-9:00)

The SDCC has sorted through the 2009 Plan and pulled the information pertaining to our Shore Drive area and has listed it below with some basic background wording.  These are just a few issues that may be important to you.  You may have other issues that don’t even show up in the current 2009 Plan.

Either way, please take an hour on Thursday to attend the open house and let the City know what YOU VALUE.

  1. Shore Drive Corridor Special Focus Area (SFA) – This 3 page chapter list general policies such as: road improvements for safety; continuous multipurpose trail; replace Lesner Bridge.  It also identifies 3 main areas of focus: (Pleasure House Point, Lynnhaven Boat Ramp, Waterman’s Walk).  Pleasure House Point has been resolved.  Other actions are still working.  Click here to read this section
  2. Water Resources Management Plan – This section touches slightly on protecting waterways for habitat and recreational use.  No mention of a Neighborhood Dredge Plan, it is recommended that this complicated plan be identified and explained in the Plan.  Click here to read this section
  3. Bicycle and Pedestrian Transportation – This sections identifies the need for a Complete Streets policy, which is currently being reviewed for implementation.  It also talks about connecting neighborhood and improving safety.  Click here to read this section
  4. Sea Level Rise – Although this section offers eight suggestions, many new issues have come up in the past 5 years.  It is recommended that the issue of Sea Level Rise be expanded and detailed more with suggestions for home raising, flood insurance support, etc. Click here to read this section



The 2009 Comprehensive plan and details can be found on the City’s website by clicking here

What is a Comprehensive Plan?

The ‘plan’ is City Council’s official statement regarding how the physical development of the City should be directed for at least the next 20 years. It must be stressed, however, that the Comprehensive Plan (the ‘Plan’ hereinafter) does not claim and should not claim to have precise answers to all of the issues that may arise over time. The Plan’s role is the establishment of the policy framework within which operates a continuous planning process. That process is a vital means of implementing the recommendations of the Plan and revising the Plan as necessary in response to the unseen issues and opportunities that the future always provides. In that regard, this Plan is a ‘living plan,’ as it is not intended for the Plan to remain just as it is when adopted. The intent is for the Plan to interact with the various situations where it has a role and to be open to change as necessary to respond to recognized challenges and opportunities. The Plan should always be evolving in response to its environment.

Why does the City have to have a Plan?

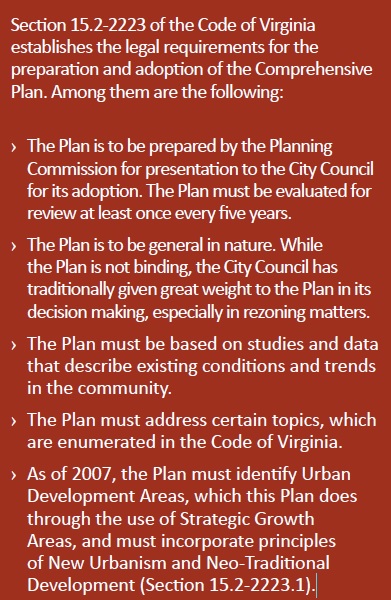

Comp Plan Rules

#LESNERBRIDGE update from Project Manager – HRSD, lane closures & bulkhead at LBR&BF

October 30th 2014 UPDATE:

Happy Halloween! Our news update for the bridge project is in NO WAY as frightful as the candy-craving minions who will be roaming the streets of Virginia Beach this evening!

The installation of the conduits beneath Shore Drive and East Stratford Street has been completed. For these next two weeks there are no scheduled daytime lane closures within the Lesner Bridge project limits.

Beginning on Monday, November 3rd, however, the Hampton Roads Sanitation District (HRSD) will begin their work on the existing sanitary sewer forcemain in WB Shore Drive. HRSD will mobilize two construction crews; one located at Shore Drive/Rockbridge Road and one at Shore Drive/Kleen Street. They will begin work on the active forcemain in order to remove from service the portion of this forcemain that crosses the existing westbound Lesner Bridge.

The first week of HRSD’s work will involve setting up their traffic control. None of this work will require long term lane closures on Shore Drive. There will likely be daytime lane closures the week of November 3rd as they setup the temporary barrier service on westbound Shore Drive at Kleen Street and build the temporary lane shift at Rockbridge Road.

The actual work to excavate, cut and cap the forcemain will take place the week of November 10th through Saturday November 15th. Restoration work of the roadway and work areas will take place the week of November 17th. All work, including equipment demobilization and removal of the temporary traffic control, should be completed by November 24th.

As for the latest bridge construction progress:

Ø Construction of the new bridge abutment “A” continues on the west side of the Lynnhaven Inlet. The first concrete pour on the new bridge abutment took place on Wednesday, October 29th. Placement of the reinforcing steel and formwork for the second tier of the abutment will take place the week of November 3rd.

Ø All of the drilled shafts at Piers 1 and 2 have been installed. Over the next two weeks the Contractor will mobilize equipment to Pier #3, the first in-water pier to be constructed on this project. Also within the next two weeks the Contractor will begin preparing the excavation at Pier #1 for the formwork of the concrete cap.

The temporary bulkhead at the Lynnhaven Dredge Material Storage Site (LDMSS) continues. The tie-back system on the new bulkhead is nearly complete. Construction of the tie-back and waler system on the temporary bulkhead will be completed by Wednesday, November 5th. Placement of the formwork and steel reinforcing for the concrete cap on the bulkhead will also continue through November 5th.

Wick drain installation for the new westbound bridge approach located on the east side of the bridge between Page Avenue and the existing bridge abutment continues. On the west side of the bridge – in front of 3556 On the Bay Condominiums – the subgrade has been prepared for the foundation of the new retaining wall. Between November 5th and November 7th the Contractor will begin to form and place the concrete footing support for the new retaining wall. Delivery of the first concrete panels for the new wall is expected Friday, November 7th.

On the east side of the bridge drainage work also continues. The new storm drainage structures are being placed along Cape Henry Drive in front of Bubba’s and the Lesner Inn. The temporary steel sheeting installed at the corner of Shore Drive and Vista Circle will be removed between November 5th and November 7th. After this is removed, work will begin to install 36-inch stormwater pipe from the structure to the existing 36-inch pipe located on the south side of Cape Henry Drive.

At some point during this construction Cape Henry Drive will be reduced to one lane and the Contractor will have to provide a flagger to control traffic on this road until the new pipe can be installed. Once we have a better idea of schedule for this work, we will issue another project updated with specific dates and estimated duration of the work.

Finally, unrelated to the bridge construction but contributing to the amount of construction work now taking place within the Lynnhaven Inlet and along Cape Henry Drive, is the Dominion Virginia Power (DVP) transmission line rehab work. This is just an FYI to all of you who are curious as to what is going on with the old transmission lines and towers.

DVP is replacing a number of wooden poles and structures along Cape Henry Drive and along the south side of Shore Drive near the Lynnhaven Boat Ramps with galvanized steel monopoles. They will also be installing two new transmission line towers to replace the two aging towers that are currently located in the Lynnhaven Inlet. The new tower on the east side of the inlet (by the Virginia and Maryland Pilots Association) will be installed approximately 210 feet east of the current tower location. The new tower on the west side of the inlet (Lynnhaven Boat Ramp) will be installed approximately 25 feet west of the current tower location. This will result in a new tower spacing of 810 feet that is significantly greater than the current 575 foot spacing.

That’s it for now. Have a safe driving weekend, and keep an eye out for those munchkins roaming the streets tonight!

-Chris

Christopher J. Wojtowicz, P.E.
Project Manager
City of Virginia Beach
Department of Public Works
Municipal Center-Bldg 2
2405 Court House Drive
Virginia Beach, VA 23456-9031
Phone: (757) 385-5785

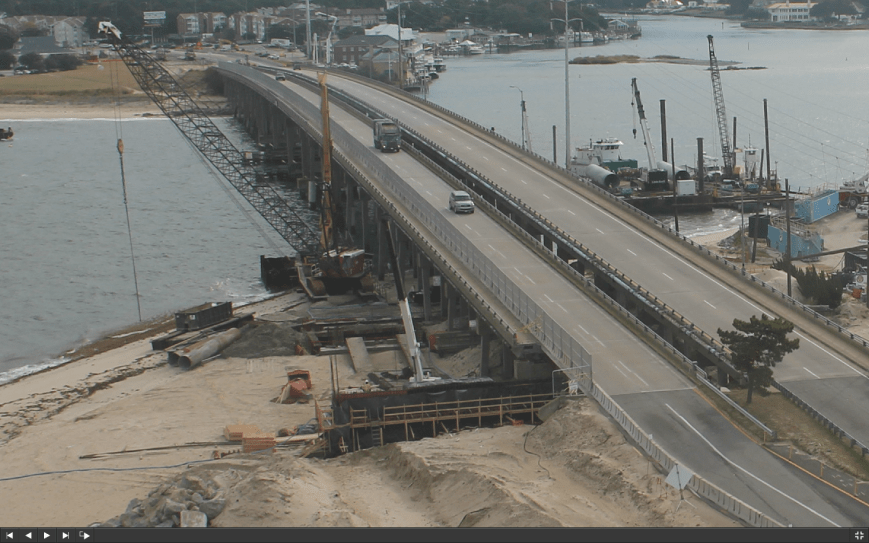

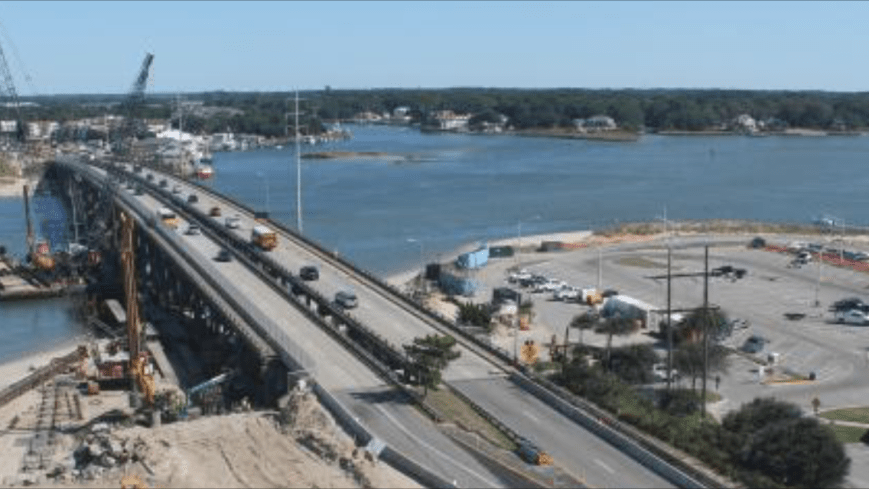

Zoomed in screen shot of construction cam photo taken at 10am OCT30 2014

Zoomed in screen shot of construction cam photo taken at 10am OCT30 2014

Join us for our Meeting Monday October 27th at 730pm at Ocean Park Volunteer Rescue Squad, includes Project Manager for Lesner Bridge Q & A

Click here for a printable version of the agenda MONDAY 27 OCTOBER 2014

MONDAY 27 OCTOBER 2014
Shore Drive Community Coalition

SDCC General Meeting
MONDAY 27 OCT 2014

7:30-8:30 pm

Where: Ocean Park Volunteer Rescue Squad Station (Intersection of 3769 Shore Drive and East Stratford Rd.)

Call to order:

Meeting topic: Lesner Bridge Construction Project
Presented by Chris J. Wojtowicz
Project Manager, City of Virginia Beach

Officers’ Reports:President’s Report David Williams
Vice President’s report Rick Mercadante
Secretary’s Report Todd Solomon –SEPT Minutes
Treasurer’s Report Paulette Hruska

Old Business
New Business

Adjourn

Next SDCC- Monday November 24, 2014
Ocean Park Volunteer Rescue Squad Center

Please check http://www.sdcc.info for more information on area news and events

Zoomed screen shot of Construction Cam photo taken at noon on Oct 21 2014

Zoomed screen shot of Construction Cam photo taken at noon on Oct 21 2014

“Every five years, Virginia Beach takes a new look at its long-term plan for growth and development. It’s called the Comprehensive Plan, “It’s Our Future,” and we need your input.”

That means you!

One of the reasons you still have time to comment is the work that Shore Drive Community Coalition – your neighbors – does to ensure We The People have a stronger voice.

Updates, info & more at VBGov.com.
Virtual Town Hall to share your input now. IMG_1347.JPG

Have a voice in your neighborhood now!

#LESNERBRIDGE update from Project Manager – includes notice of lane closures next week October 17th 2014 Update

October 17 2014 UPDATE:

Expect more daytime lane closures today, as well as Monday and Tuesday of next week on eastbound Shore Drive between East Stratford Street and the Lesner Bridge.

Today, October 17th and Monday October 20th, the electrical contractor will complete the boring of the new electrical conduit beneath East Stratford Street from the Sushi Restaurant to J&A Racing. Then on Tuesday October 21st the contractor will repair several potholes that have formed on Shore Drive east of East Stratford Street.

*** This work will require a SINGLE LANE CLOSURE on eastbound Shore Drive between East Stratford Street and the Lesner Bridge between the hours of 9:00 am and 3:00 pm for each day of work.

During this work, a police officer will be located at the intersection of Shore Drive and East Stratford Street to assist with vehicles entering and leaving East Stratford Street from Shore Drive.

The last project update mentioned that several recently placed concrete traffic barriers located on westbound Shore Drive between Page Avenue and the Lesner Bridge had to be replaced and would also require a daytime westbound lane closure to do this work. In lieu of replacement, the contractor is considering repair of these three temporary barriers. Because of that, no daytime lane closure on westbound Shore Drive at Page Avenue is planned at this time.

As for the latest progress:

Construction of the new bridge abutment “A” continues on the west side of the Lynnhaven Inlet. Formwork for the new westbound bridge abutment is now being constructed and is expected to be completed by October 24th. Concrete for the new abutment will likely be placed the week of October 27th.

Two of the four 4’ diameter x 95’ deep shafts have already been constructed at bridge Pier #2. Construction of the two remaining shafts at Pier #2 will be completed by the week of October 20th.

The temporary bulkhead at the Lynnhaven Dredge Material Storage Site (LDMSS) continues. The tie-back system on the new bulkhead will begin to be installed the week of October 20th and is anticipated to be complete by Friday, October 24th. The formwork for the concrete cap on the temporary bulkhead will likely be completed by October 31st.

Grading and preparation of the new westbound bridge approach located on the east side of the bridge between Page Avenue and the existing bridge abutment continues. The contractor is currently excavating the foundation for the new retaining wall that will be installed between 3556 On the Bay Condominiums and Shore Drive.

They also are continuing to install wick drains in the westbound bridge approach area between Page Avenue and the bridge. (“Wick Drains” are being used to accelerate the consolidation of a soft, compressible clay layer that exists approximately 50 feet below grade. As we place select fill material to build up the new bridge approaches, we want to accelerate and greatly increase the consolidation and settlement of this soft layer prior to building the new roadway).

We will continue to keep you informed of our progress as we move forward with this important project.

Have a safe driving weekend!

-Chris

Christopher J. Wojtowicz, P.E.
Project Manager
City of Virginia Beach
Department of Public Works
Municipal Center-Bldg 2
2405 Court House Drive
Virginia Beach, VA 23456-9031

Zoomed in screen shot of construction cam photo taken at 2pm OCT17 2014

Zoomed in screen shot of construction cam photo taken at 2pm OCT17 2014

#LESNERBRIDGE update from Project Manager – includes notice of lane closures next week

October 10th 2014 update:

Last week we sent out an update on the progress of the Lesner Bridge construction. Before we give you the latest update, we want to let you know now about upcoming lane closures.

On Monday, October 13th and Tuesday October 14th, the electrical contractor will be boring new electrical conduit beneath East Stratford Street from the Sushi Restaurant to J&A Racing. Then on Wednesday October 15th and Thursday October 16th, the electrical contractor will bore beneath Shore Drive from the Sushi Restaurant to the corner near 3556 On the Bay.

*** This work will require a LANE CLOSURE on eastbound Shore Drive between DuPont Circle and East Stratford Street between the hours of 9:00 am and 3:00 pm for each day of work.

During this work, a police officer will be located at the intersection of Shore Drive and East Stratford Street to assist with vehicles entering and leaving East Stratford Street from Shore Drive.

Also, no specific day was given by the contractor, but one lane of westbound Shore Drive will be temporarily closed next week from Page Avenue to the existing bridge so that several of the recently placed concrete barriers can be replaced.

This lane closure, when it happens, will take place sometime between the hours of 9:00 AM and 3:00 PM. As soon as we get a firm date and time, we will send out the information to you.

As for the latest progress:

As of today, all of the drilled shafts for the new bridge abutment “A” and Pier #1 located just east of 3556 On the Bay condominiums have been completed. Equipment has been relocated to Pier #2 and drilling of the shafts at Pier #2 has begun. It is expected that all of the drilled shafts for Pier #2 will be completed by the week of October 20th.

Just in case some of you were wondering, spacing between the pier centerlines is 150 feet, except for the center span of the new bridge. Pier spacing at the center span is 225 feet.

The temporary bulkhead at the Lynnhaven Dredge Material Storage Site (LDMSS) continues. The deadmen for the tie-back system on the new bulkhead has been installed and formwork for the concrete cap continues to be installed. This work will continue through at least the week of October 20th.

Grading and preparation of the new westbound bridge approach located on the east side of the bridge between Page Avenue and the existing bridge abutment continues. Over the next two weeks the excavation contractor will be preparing this area, as well as the area between East Stratford Street and the existing bridge, for the new retaining wall that will be located on the north side of Shore Drive.

This bridge project will also relocate and replace the existing traffic signals located at either end of the bridge; one at Shore Drive/East Stratford Street and one at Shore Drive/Vista Circle/Page Avenue. The work will take place in phases over the next several months.

That’s it for now.

Have a Safe Driving Weekend!

-Chris

Christopher J. Wojtowicz, P.E.
Project Manager
City of Virginia Beach
Department of Public Works
Municipal Center-Bldg 2
2405 Court House Drive
Virginia Beach, VA 23456-9031

Emphasis ours.

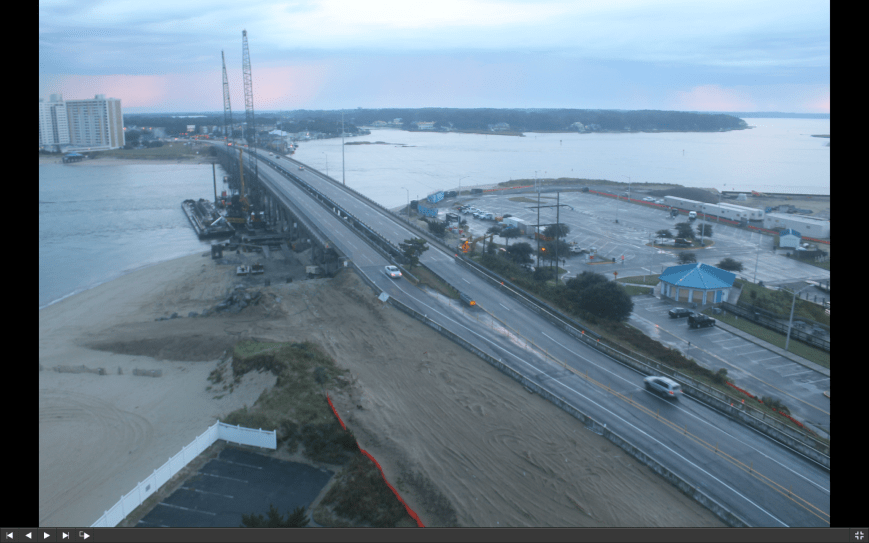

screen shot of Construction Cam from today at 730a

screen shot of Construction Cam from today at 730a

#LESNERBRIDGE 1 lane both directions

We do not know why or for how long.

That being said, the next anticipated lane closure related to the bridge work will occur on westbound Shore Drive between the bridge and Page Avenue next Monday, October 6th and Tuesday October 7th.

Please spread the word.


#LESNERBRIDGE update from Project Manager – “To begin this update, the project team has received a number of requests from citizens to have more consistent project updates.”

The October 2 2014 update:

To begin this update, the project team has received a number of requests from citizens to have more consistent project updates. We are glad to do that, so each week we will send out an update that includes a two-week “look ahead” schedule so that everyone will know what impacts from the project can be expected – including any lane closures.

With the recent lane shift on westbound Shore Drive at Page Avenue, we have completed our Phase 2 Maintenance of Traffic (MOT). This will be the new traffic pattern for at least the next 12-14 months while we build the new westbound Lesner Bridge.

Any DAYTIME lane closures that are needed will be setup by 9:00 AM and removed by 3:00 PM the same day. NIGHTIME lane closures, when they occur, will be from 9:00 PM to 5:00 AM.

That being said, the next anticipated lane closure related to the bridge work will occur on westbound Shore Drive between the bridge and Page Avenue next Monday, October 6th and Tuesday October 7th. This closure is only temporary and is needed so that the contractor can install concrete barrier service in this area and remove the orange traffic barrels (just like what was done on the west side of the bridge). It is expected that this lane closure will occur at night, but it is possible that this may occur during the day between the hours of 9:00 AM and 3:00 PM.

Over the next two weeks the contractor will complete the drilled shaft work at bridge Abutment A and Pier 1. Foundation construction will start at Pier 2 on Tuesday, October 7th 2014, and continue into the week of October 13th. During this same time period wick drains will continue to be installed along the north side of Shore Drive on the west side of the bridge (in front of 3556 On the Bay Condominiums). Abutment A is located on the west side of the Lynnhaven Inlet and Abutment B is on the eastside. There are 9 piers for each bridge. Pier #1 is located west of the inlet and Pier #9 is located on the eastside of the inlet.

All of the steel sheets for the temporary bulkhead located at the Lynnhaven Dredge Material Storage Area have been installed. During the weeks of October 6th and October 13th, formwork and the tie-back system for this bulkhead will be constructed.

The 18-inch sanitary sewer forcemain that crosses the existing westbound Lesner Bridge needs to be taken out of service for us to continue with the new bridge construction. Over the past several months, the City and the Hampton Roads Sanitation District (HRSD) have been coordinating this effort. In order for HRSD to take this large forcemain out of service, two linestops will have to be installed in the line; one at the intersection of Shore Drive and Rockbridge Road and one just west of Kleen Street (in front of Mango’s Grill).

HRSD will not implement any lane closures for this work, but they will need to install a concrete barrier along the shoulder west of Kleen Street, and install some temporary pavement in the median of Shore Drive across from Rockbridge Road. They anticipate this work to begin the week of October 13th, 2014 and continue thru Friday, October 17th. This schedule is subject to change, but we will provide a more up-to-date schedule in next week’s Lesner Bridge project update.

As a reminder, the speed limit over the Lesner Bridge is 35 MPH. Although it’s easy to exceed 35 MPH on Shore Drive, the temporary lane shifts on Shore Drive at both the eastbound and westbound Lesner Bridge are only designed for 35 MPH. Exceeding this speed limit through the construction zone not only risks your safety, but the safety of the bridge construction workers and any pedestrians/cyclists crossing the bridge.

Thanks to everyone who has contributed helpful tips for how we could make things better for the road users through this busy corridor!

Emphasis ours.

# # #

Follow @LesnerBridge in Twitter!

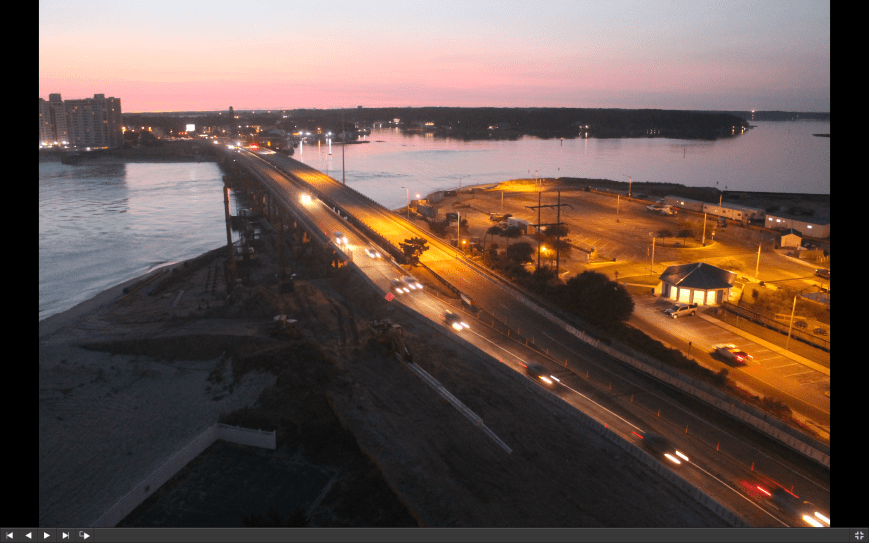

Screen Shot 2014-10-03 at 9.38.01 AM

ROAD CLOSED sign being changed at #LESNERBRIDGE to improve safety on Shore Drive

Some of you, including me, have been thrown off by the ROAD CLOSED sign on the east side of the #LESNERBRIDGE.

It’s being changed.

Please have McLean remove the ROAD CLOSED sign from the TYPE III Barrier located on WB Shore Drive at Page Avenue and replace it with a WI-6 ARROW. Also have them replace the TYPE III barricade with one that has hash marks as shown in the attached plan.

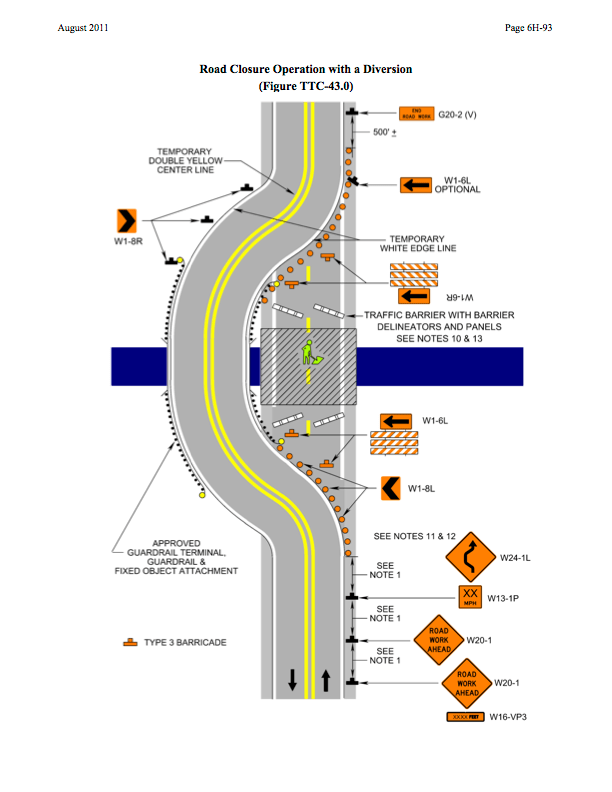

Page 6H-93 of Virginia WAPM

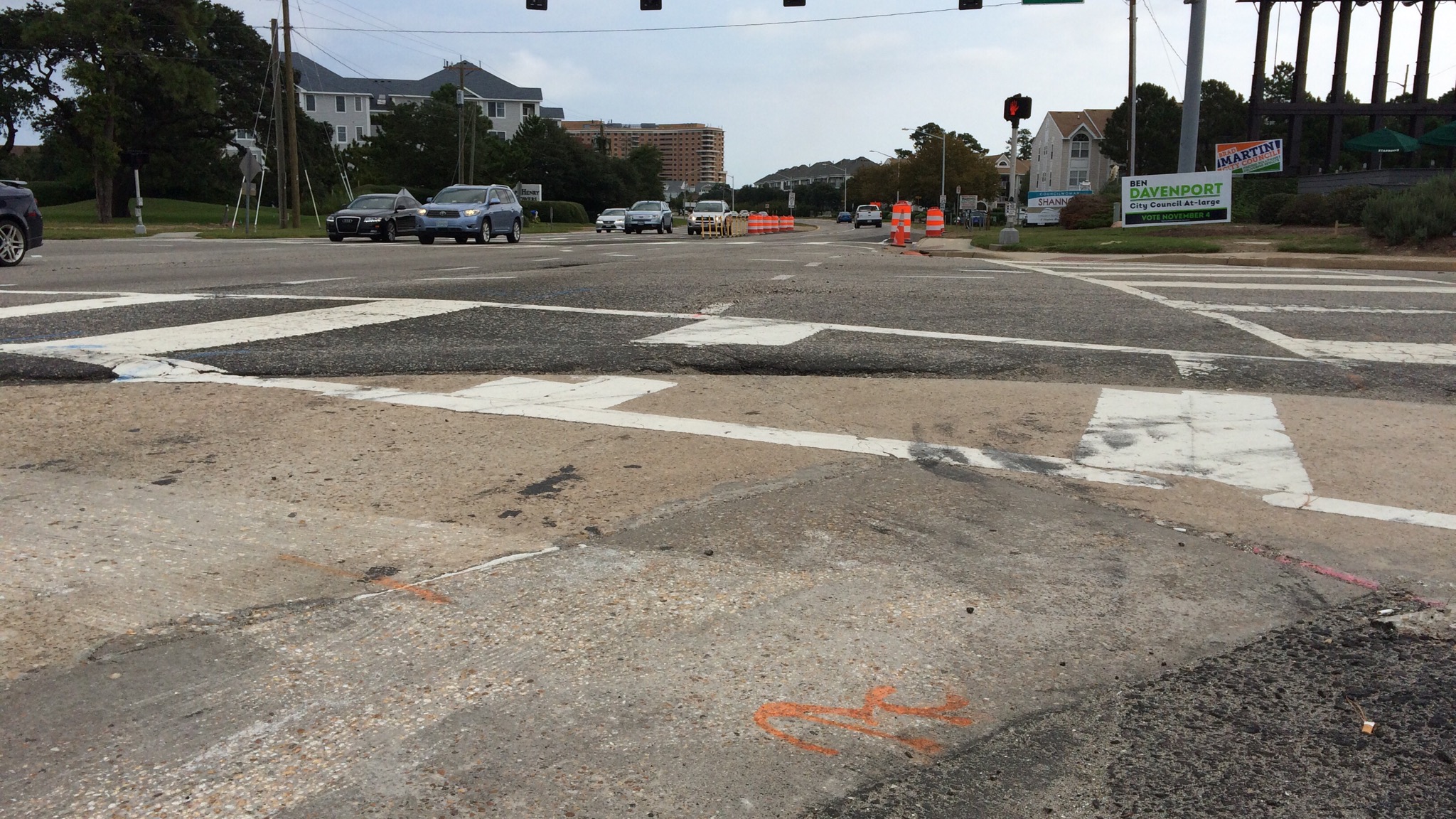

#LESNERBRIDGE photo update

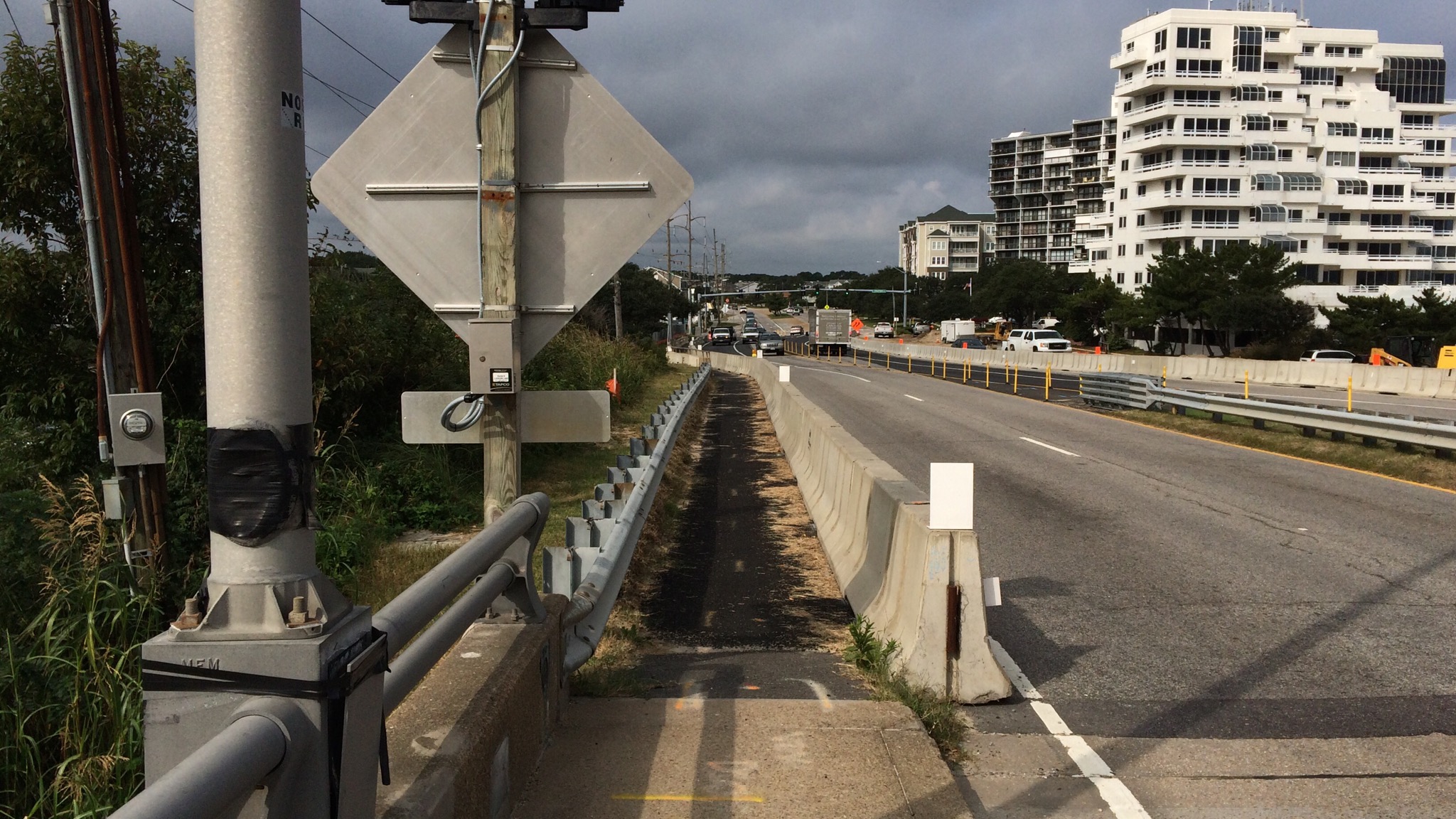

Lanes shifted on east side.
Not sure why the choice is a ROAD CLOSED sign vs one of those shifting arrows signs.


Understand the infamous “speed bump” eastbound Shore Drive at Vista Circle/Starbucks will be repaired.

MUP won’t be blocked by parked vehicles again.

Be safe!

MUP = Multi Use Path
